You are here: HOME > NEWS > 3 Ton Rice Mill Project Cost: Complete Budget Worksheet

3 Ton Rice Mill Project Cost: Complete Budget Worksheet

Time:2023-03-30

Quick answer: A 3 ton rice mill project cost is the complete installed budget, not only the machinery price. Calculate it as process equipment + building and site work + power and utilities + delivery and import + installation and commissioning + startup reserve and working capital. First confirm whether 3 ton means paddy input per hour, finished-rice output per hour or daily production.

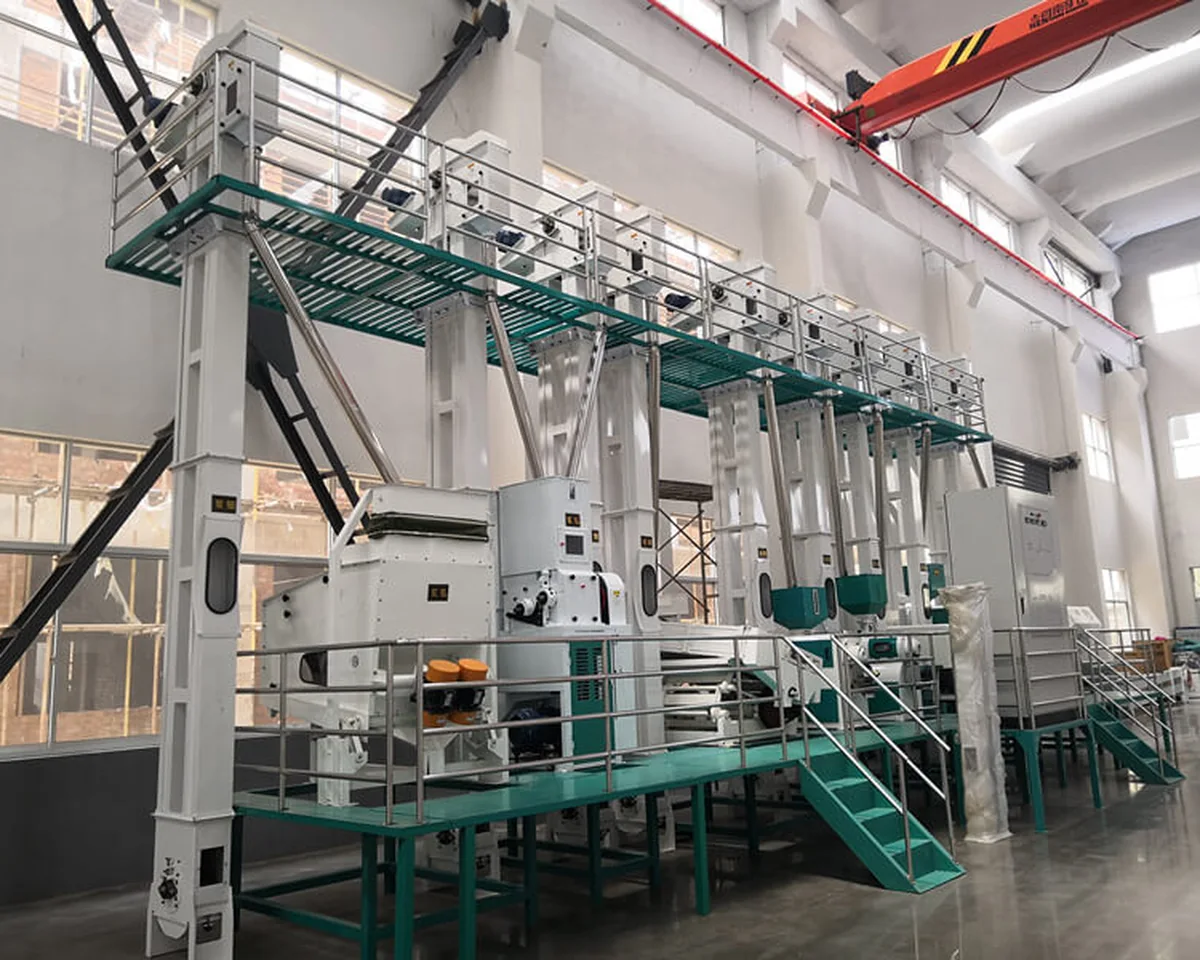

Three ton rice mill project layout and complete budget planning
A complete project budget connects the machinery line with the building, utilities, delivery, installation and startup plan.

3 ton rice mill project cost worksheet

Use one worksheet for all investment items and identify the source of every estimate. Machinery can be quoted by the supplier, while civil work, power connection, import charges and local labor normally require local quotations. Keeping these sources separate makes later revisions easier.

Budget section Typical items Evidence to collect
Process equipment Cleaning, husking, separation, whitening, polishing, grading, sorting, conveying and packing Process flow, model list, motors, capacity assumptions and quotation
Building and site Land preparation, foundations, pits, platforms, warehouse, roads and drainage Dimensioned layout, loads, local quantities and contractor quote
Power and utilities Transformer, panels, cables, generator, compressed air, water and dust collection Motor schedule, utility demand and local supplier estimates
Delivery and import Packing, inland transport, ocean freight, insurance, customs and destination delivery Incoterm, packing list, freight quote and local import calculation
Installation and startup Unloading, erection, travel, local labor, commissioning, training and trial paddy Responsibility matrix, schedule and acceptance-test plan
Operating reserve Spare parts, packaging, paddy stock, payroll, maintenance and working capital Startup plan, supplier lists and local operating assumptions

Step 1: define the capacity basis

A budget cannot be reliable until the capacity is clear. Three tons of paddy entering the line does not equal three tons of finished rice leaving it. Record paddy input, expected finished-rice output, operating hours per shift, shifts per day and annual working days. Add paddy moisture, impurity level, variety and required finished quality because these affect both equipment and operating assumptions.

If the buyer is still comparing machinery configurations, use the separate 3 ton rice mill machine price guide. That page covers the equipment quotation without mixing it with local construction and startup costs.

Step 2: establish the process and equipment scope

Prepare one process flow from paddy intake to finished packing. Decide whether the project requires destoning, polishing, color sorting, automatic packing, dust control, bran handling and grain storage. The model list must be balanced so a smaller separator, grader or packer does not reduce the output of the full line.

Obtain the machinery quotation with motors, conveyors, bins, controls, platforms, spare parts, documents and service boundary stated clearly. Keep optional equipment separate so the buyer can compare a base case with a higher-quality or more automated case.

Step 3: calculate building and site cost

The equipment layout gives dimensions and loads, but local contractors should price excavation, foundations, floor, drainage, structure, roof, warehouse and access roads. Include enough height for gravity flow, maintenance clearance around machines, safe platforms and routes for paddy, finished rice, husk and bran.

Do not use a building estimate from another country without adjustment. Labor rates, materials, codes, climate, fire protection and ground conditions vary. The rice mill construction and factory setup guide provides a more detailed local checklist.

Step 4: add electrical and utility infrastructure

Use the supplier's motor schedule to size the transformer, generator, distribution panels and cables. Add lighting, office and laboratory loads, compressed air for sorting and packing, water where required, dust collection and ventilation. The electrical quotation should show what is supplied with the machines and what the local contractor must install.

Utility cost also affects the operating model. Record expected power demand, tariff, fuel, water and backup-power use rather than assuming the machine subtotal represents the main long-term expense.

Step 5: calculate delivery, import and installation

Confirm the Incoterm before using a freight number. The budget can include factory-to-port transport, export packing, ocean freight, insurance, destination charges, customs duties, inland delivery, unloading and storage. Ask for a preliminary packing list when requesting logistics estimates.

Installation should identify engineer travel, accommodation, visas, local labor, lifting equipment, tools, wiring, trial material and training. A responsibility matrix prevents the supplier and buyer from assuming the other party will provide the same item.

Step 6: include commissioning and working capital

The startup budget should cover trial paddy, packaging, laboratory checks, operator training, initial spare parts and a realistic ramp-up period. Working capital can include paddy inventory, payroll, utilities, transport and customer credit before sales receipts become stable. These items are not part of the machinery price but can determine whether the plant starts smoothly.

Build conservative, normal and strong operating cases using local paddy prices, milling recovery, by-product revenue, utilization and selling prices. A small change in yield or paddy cost can have more effect on profitability than a modest equipment-price difference.

Contingency, currency and schedule risk

Record the currency, exchange rate, quotation date and validity period beside every imported cost. Freight, steel, electrical materials and local construction prices may change between budgeting and purchase. Keep a visible contingency allowance instead of hiding uncertainty inside the machinery subtotal, and apply it according to the maturity of each estimate.

Update the worksheet at design approval, equipment order, shipment and installation. Also connect payment milestones to the cash-flow plan, because deposits, freight, customs, construction and working capital may fall in different months. A project can be affordable in total but still face a funding gap if the payment schedule is ignored.

How to compare complete project proposals

Comparison test Required answer Reason
Same capacity Identical input, output, shifts and paddy assumptions Prevents comparison of different plant sizes.
Same process Identical quality stages and packing scope Shows whether a lower price omits required machines.
Same boundary Clear supplier, local contractor and buyer responsibilities Exposes hidden civil, utility and installation costs.
Same delivery basis Identical Incoterm and destination Makes freight and import estimates comparable.
Same acceptance method Throughput, yield, quality and test conditions Connects the budget to a measurable result.

How VOSON prepares a project estimate

Our review begins with paddy data, finished-product target and production schedule. We prepare the process flow and equipment schedule, then identify building loads, utilities, delivery, installation and test responsibilities. Local costs remain visible rather than being hidden inside an unsupported global total. This method allows buyers to update freight, construction or operating assumptions without rebuilding the machinery scope.

Use the Rice Mill Project Planning Hub for the full workflow, compare a larger 4 ton project budget, or send site and production data through Contact. For independent background on milling stages, consult the International Rice Research Institute Rice Knowledge Bank.

3 ton rice mill project cost FAQ

Is machinery price the same as total project cost?

No. Total project cost can also include construction, power, freight, import charges, installation, commissioning, spare parts and working capital.

Does 3 ton mean paddy input or finished output?

It can mean either. The estimate must state the exact basis, hourly or daily period and expected milling recovery.

Should land be included?

Show land separately because ownership, lease terms and local prices vary widely. Do not hide it inside the machinery or building subtotal.

Which local quotations are needed?

Typical local quotations cover civil work, power connection, transformer, cables, freight at destination, customs, unloading, labor and utilities.

Should working capital be included?

Yes. Paddy stock, packaging, payroll, utilities and the startup sales cycle can require substantial cash beyond fixed equipment investment.

How should buyers compare project proposals?

Use the same capacity, paddy, process, delivery term, installation boundary and acceptance standard, then mark every exclusion.
